Project Management

Cost Loading, Weight Value and Overall S-Curve

Published 05 May 2021

Schedule resource loading is notoriously challenging. On the contrary, cost loading a schedule as per the cost report (BOQ cost) is often considered one of the easiest tasks. The process seems simple: locate the activities related to each cost item, then assign the cost value.

The $90 Million Mistake

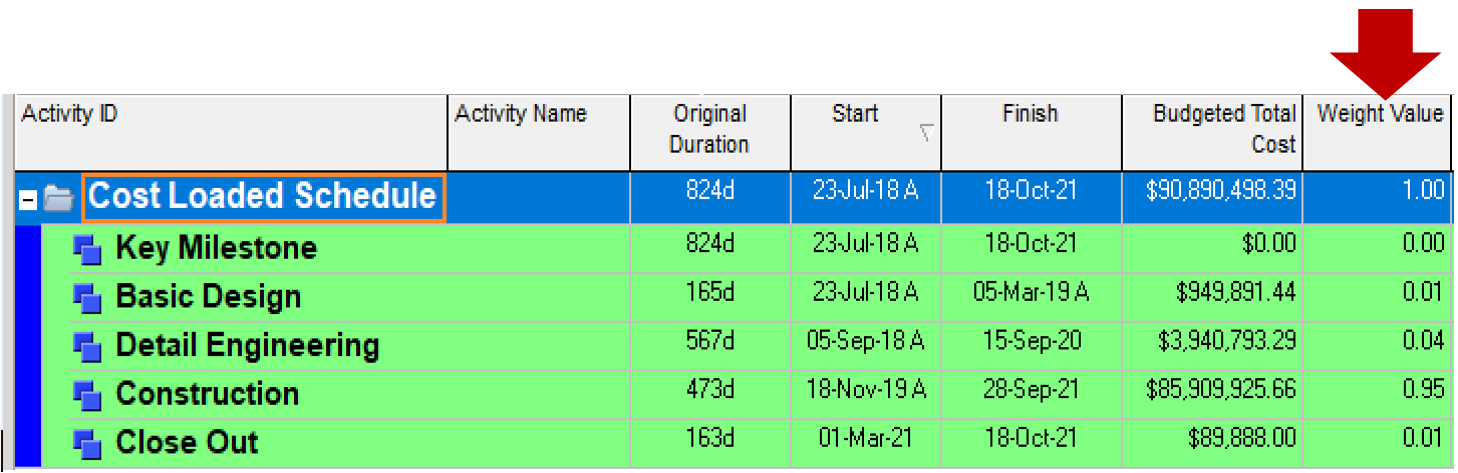

In a recent $90 million project, the planner assigned costs directly to the activities. The resulting distribution showed Construction at a massive 95% weight, and Detail Engineering at a mere 3.5%.

P6 Direct Extraction S-Curve

The Contractual Reality Check

When the contract and cost reports were properly reviewed, two critical errors emerged:

  • 1. Commingled Costs

    The Engineering cost for many activities was incorrectly combined with Construction costs.

  • 2. Ignored Contractual Weights

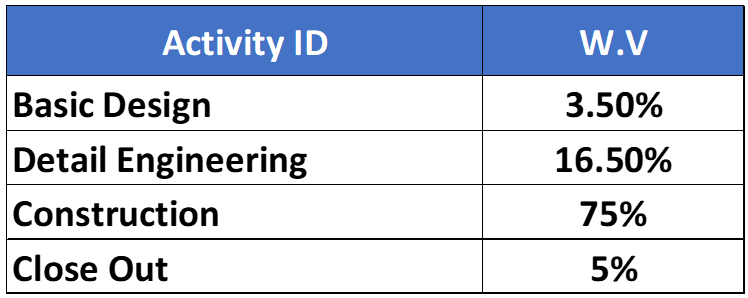

    Mandatory contractual weight values were completely bypassed when developing the overall S-Curve and progress report.The contractual weight values were like the following table:

P6 Direct Extraction S-Curve

The Tale of Two S-Curves

The Flawed S-Curve (Direct P6 Extraction)

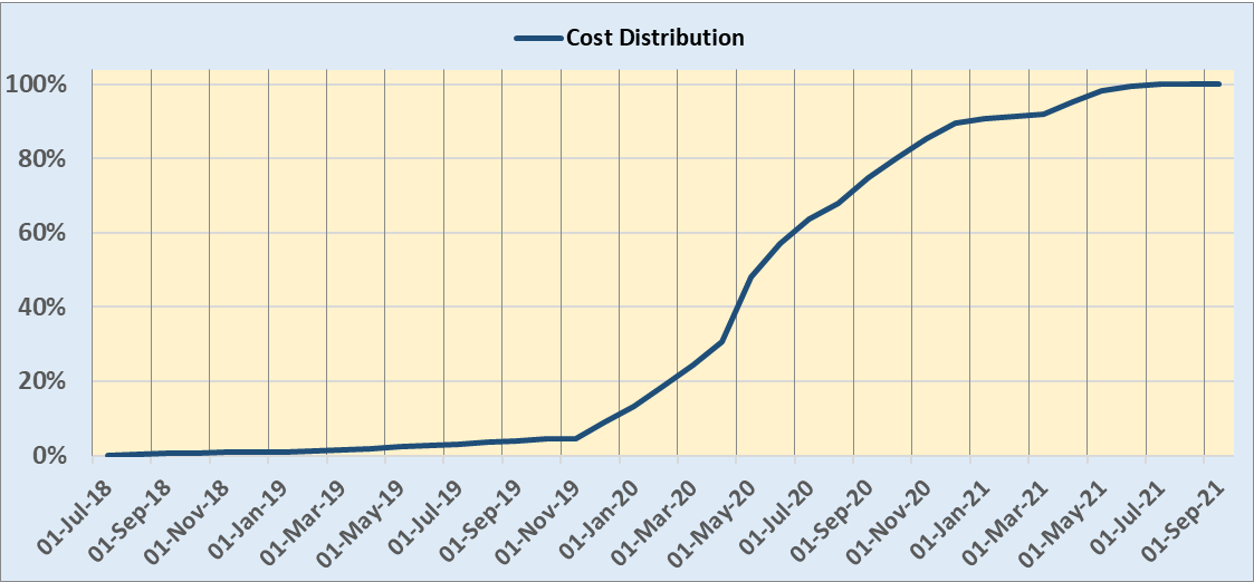

Due to No.1 above, the cost loading could not be acceptable which as a result directly affected the weight values, overall S-Curve and Progress! After completion of the Cost loading, five S-Curves were developed: Basic Design, Detail Design, Construction, Close Out and Overall. To develop the Overall S-Curve, the data was extracted directly from P6 and contractual weight values were ignored. The developed S-Curve as follows:

P6 Direct Extraction S-Curve

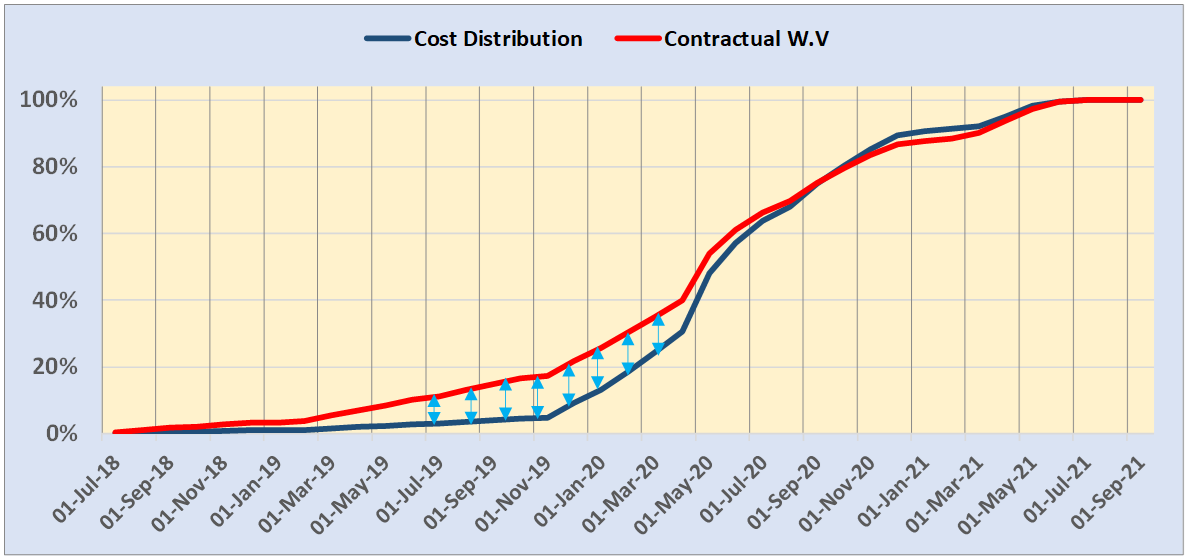

The Corrected S-Curve (With Contractual Weights)

Once the required contractual weight values were applied, the chart shifted dramatically, revealing a terrifying reality: a gap of more than 12% in some periods.

P6 Direct Extraction S-Curve

The Delusion of Progress

In December 2019, if the actual progress was 10%, the team looking at the flawed first chart assumed they were 5% ahead of schedule.

In reality, based on the correct weighted chart, they were 10% behind.

Would a project operating under this delusion finish on time or within budget? Unlikely. As per recent reports, that specific project is now 9 months behind schedule, largely due to a misleading planning and reporting system.

Is Your Planning System Lying to You?

A planning system MUST support the PM with reality, not misleading variables. Don't assume your setup is correct. We provide comprehensive gap analysis reports to fix these exact issues.
