Project Management

Engineering and Procurement Level of Detail

Published 15 February 2021

A reliable Engineering schedule requires more than just dates. Tt requires a profound understanding of the interfaces among disciplines, deliverables, and construction.

What a Planner Must Master

To support a project effectively, a planner cannot treat Engineering as a single "block." Planner must be able to map the complex relationships among:

Engineering Deliverables & Disciplines
Procurement and 3D Model Development
Engineering and Construction Needs
Man-hour Estimation & Resource Loads
Rework & Revision Management

When planners lack experience, they often simplify Engineering and Procurement to a much higher level than Construction. The result? Activities with long durations and logics built on arbitrary Start-to-Start + Lag relationships.

The "SS + Lag" Illusion

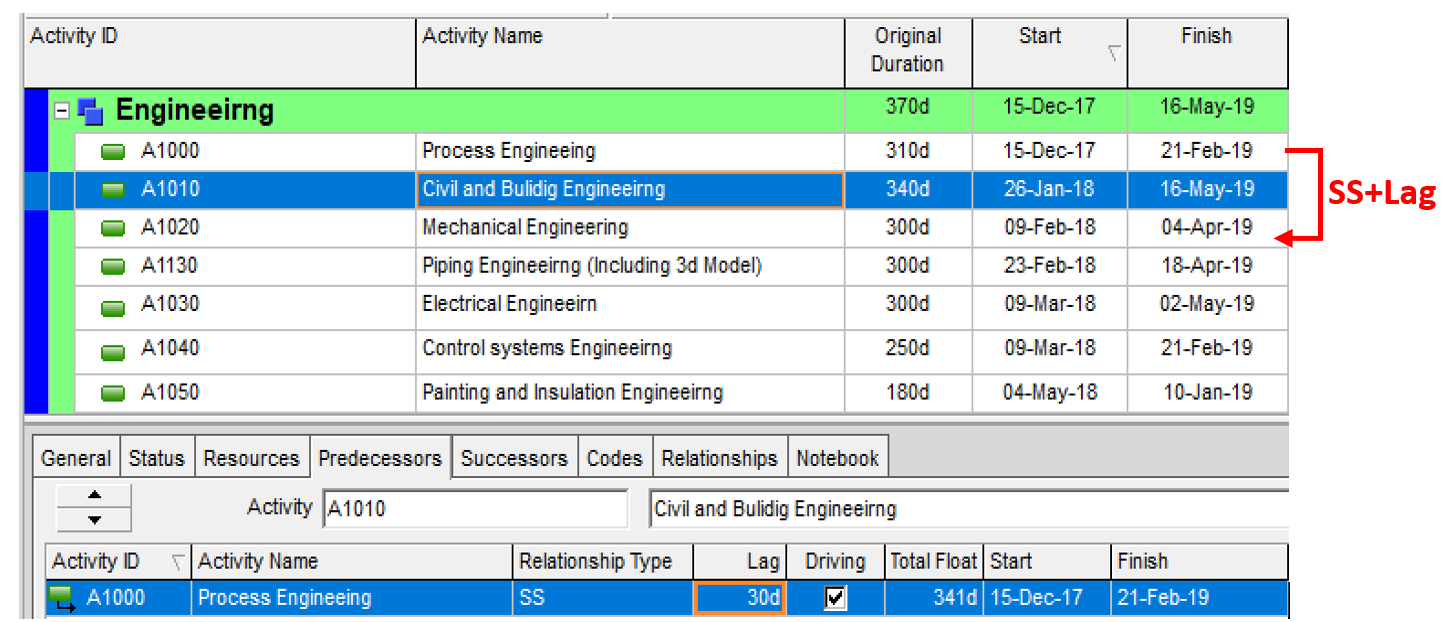

Engineering Level of Detail Analysis

Similar flaws methodology apply in Procurement scheduling. Long Durations without granular logic, the relationship between Engineering milestones and Procurement cycles becomes a guessing game.

Procurement Complexity

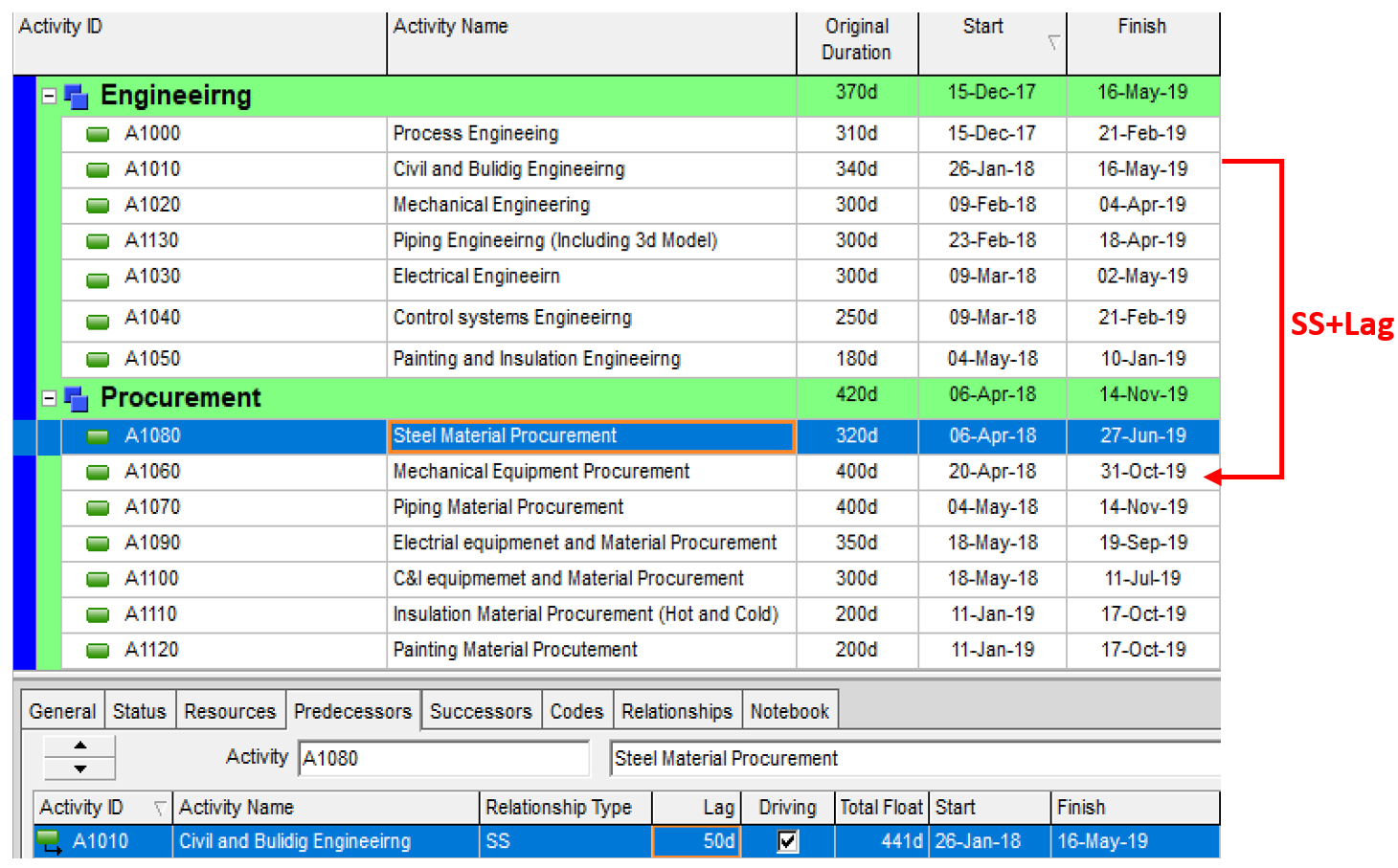

Procurement Logic Flow

The Price of Low Detail

Baseless Lags: Lags are added arbitrarily just to force dates to look "right."
Flawed S-Curves: Progress curves become straight lines or entirely incorrect.
Last-Minute Drama: E&P delays are hidden until they impact Construction.
Impossible Analysis: Delay analysis and forensics become impossible to justify.
Blind Risks: Resource and risk management cannot be applied to E&P.
Loss of Credibility: The schedule loses value as it fails to reflect site reality.

Audit Your EPC Schedule

Don't let high-level scheduling sink your project. We provide gap analysis and implement systems that support real delivery.

Gap Analysis • Comprehensive Reporting • System Implementation
Secure Your Project Now
