Project Management

Finish Date Analysis Based on No. of Resources, Production Rate, Working Days

Published 12 June 2023

Have you ever faced a situation where a Project Manager requested you to calculate the required number of Resources for a specific discipline, but there was no detailed Schedule or the Schedule was not resource loaded? On occasions of this nature, linear calculations are often used, assuming a fixed number of resources and a consistent production rate throughout the Project. On the contrary, that approach is far from reality due to several factors:

Why Linear Math Fails

Non-Linear Mobilization Resources get mobilized at staggered intervals, not all at once.
Weather Impact Production rates and workable days fluctuate with seasonal conditions.
Holiday Constraints Calendar events (holidays) impact weekly volume and shift finish dates.

So, what is the solution?

It’s important to note that most Scheduling Software Packages either cannot incorporate these factors or require extensive calculations and manual data entry! Under circumstances of this nature, we utilise our Khono Analysis Toolkit (KAT). Let’s take a piping Project as an example to demonstrate the KAT process.

Step 1: Project Initiation

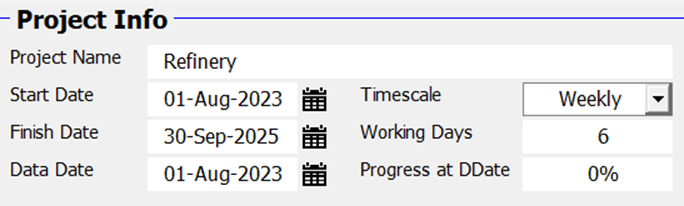

Define the project scope and core metrics within the KAT environment.

Project Info

Step 2: Holiday Integration

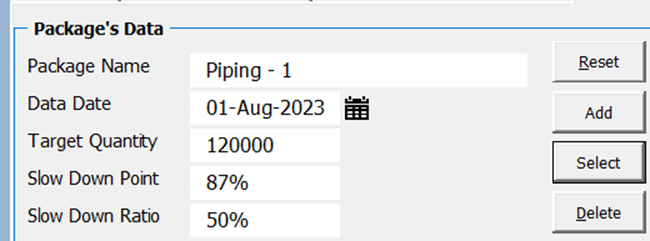

Assign specific construction holidays to generate an accurate workable calendar.

Calendar Info

Step 3: Create Scenarios

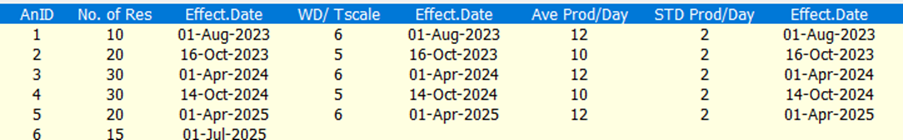

Created three scenarios based on the following Piping information

Calendar Info

Scenario Comparative Analysis

Scenario 1: Standard Mobilization

Analysis of 10 initial welders, working 6 days per week and 12ID for production rate/day, then mobilizing 20 welders, working 5 days per week and 10ID as production rate. The details as follows:

Scenario 1 Data

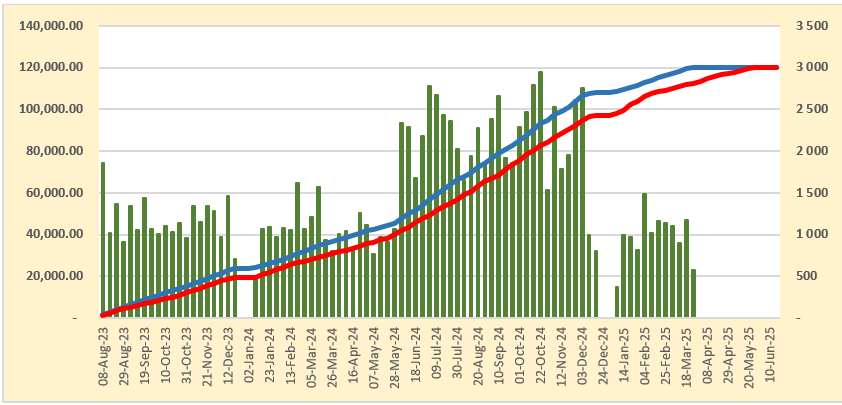

After running the KAT analysis, we obtain results in the form of charts:

Scenario 1 Data

Scenario 2: Reduced Work Weeks

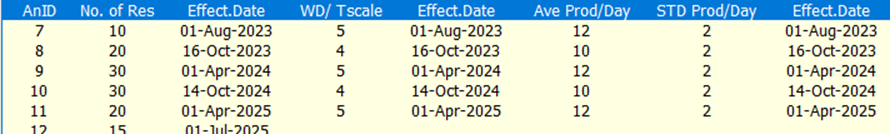

Adjustment to 5 and 4-day work weeks based on site-specific constraints.

Scenario 2 Data

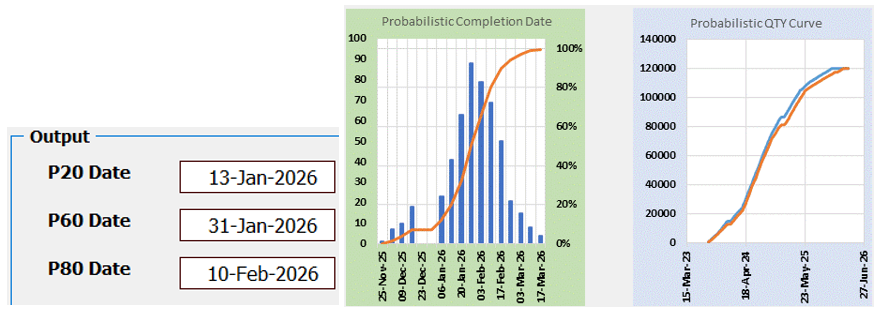

The outcome of the analysis for the second scenario is as follows:

Scenario 1 Data

Scenario 3: Skilled Resource Optimization

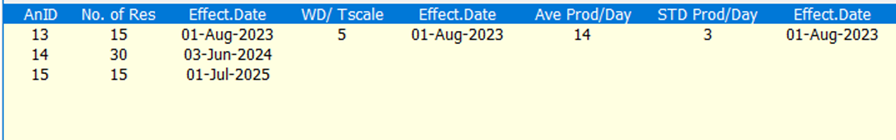

Leveraging highly skilled welders at a 14ID/day production rate.

Scenario 3 Data

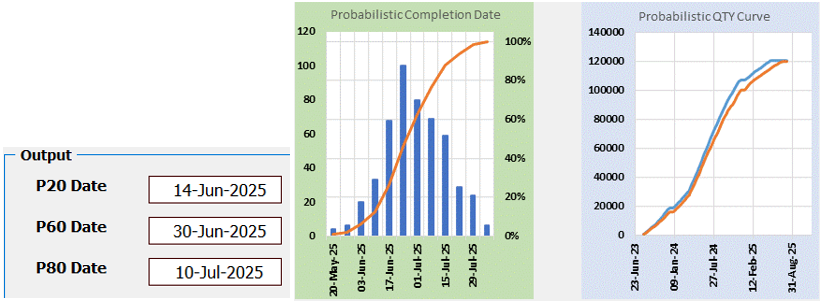

The outcome of the analysis The analysis result is as follows:

Scenario 1 Data

Strategic Outcomes

After discussing the outcomes and generating additional scenarios, it was decide to proceed with the third scenario. We can then estimate the cost of piping based on this scenario..

Scenario 1 Data

KAT also facilitates advanced Excel exports for customized project dashboarding:

Scenario 1 Data

Optimize Your Resource Planning

Model complex realities instead of relying on linear guesses. Let KAT bring precision to your next project.

Explore KAT Features
