Project Management

What is the Purpose of Integrated Master Schedule?

Published 17 May 2021

Failure in Interface management of construction projects could cause significant cost overrun, delay and easily collapse any multi-contracting project. Herein is an example of what we once witnessed.

On a multi-billion dollar project, we received an urgent request to develop a new Integrated Baseline Schedule for a multi-billion dollars’ Project in one week only (is it feasible?!). On the 1st site visit, we were invited to a meeting to observe how the weekly progress meetings are running. Surprisingly, In the meeting both client/PMC and contractor had their lawyers and senior contract managers present. But why were the lawyers present in the weekly progress meeting? We soon found out, why?

It was a multi-contract Project and the PMC was responsible for developing the Integrated Master Schedule (IMS). When the IMS was developed, the PMC team were assuming that it will be a simple high Level Schedule to report the Project’s status to the Client. There were no thought processes for interface management. In early days of the Project there were no issues with interface management because mainly civil works were in progress!

The "Lawyers in the Meeting" Phenomenon

"During MEIP installation, interface management became a monster. Contractors exploited logic gaps to make claims, and nobody could provide a reliable date for when a work area would actually be available". his was the reason for having lawyers in the progress review meetings!

After our findings report, the PMC contracted 2 consultants to develop a new IMS. The 1st one was so called global leading project management consultant and 2nd one was a local leading consultant!! After 9 months both these leading consultants failed especially the 1st one who claimed that they developed 87% healthy schedule! But when we deleted the 2 placeholder milestones, most of the activities sat on the data date!

4 Common IMS Practices

Understanding the pitfalls of standard scheduling approaches.

1. The EPS Copy Method

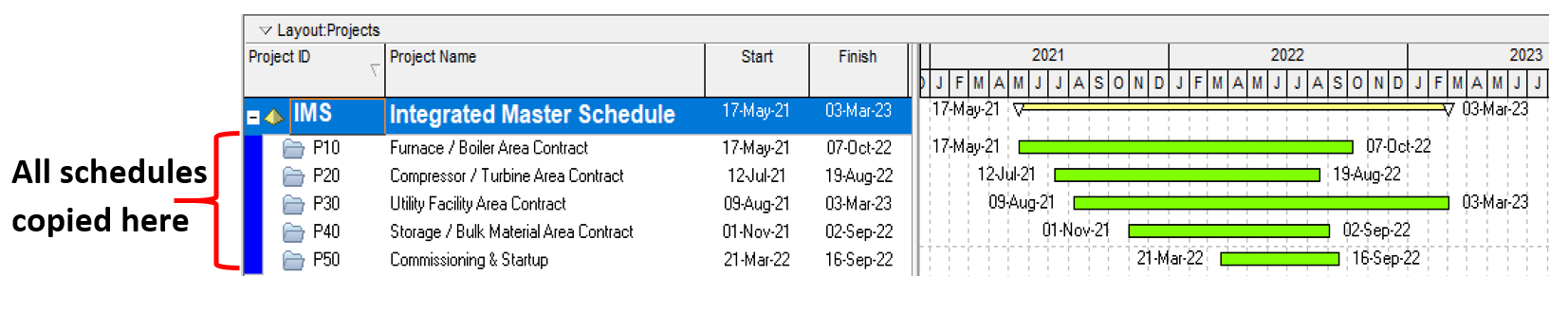

The planner, copies all the schedule in one EPS or one file. Then opens them together. No or only few links among the schedules (very simple and easy)!! For updating, the updated schedules get copied in a new EPS / file. Or the planner tries to update them automatically!

EPS Copy Method Diagram

2. Non-Systematic Linking

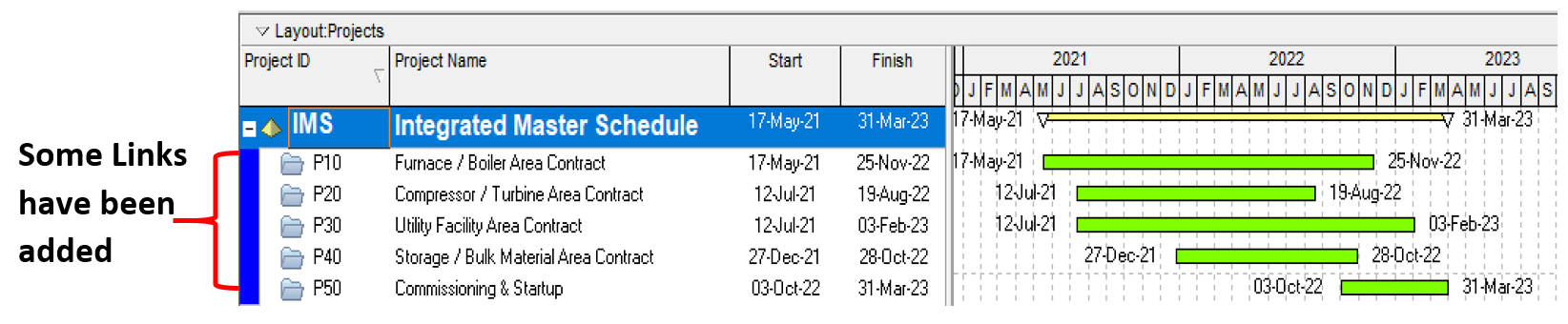

This one is almost same as the No.1 but the planner tries to add more links among the schedules. The process of adding more links could take several weeks but generally it does not get done systematically. Therefore, for every update, the planner has no choice either update automatically or redo the linking again and again!

Non-Systematic Linking Diagram

3. High-Level Manual Reporting

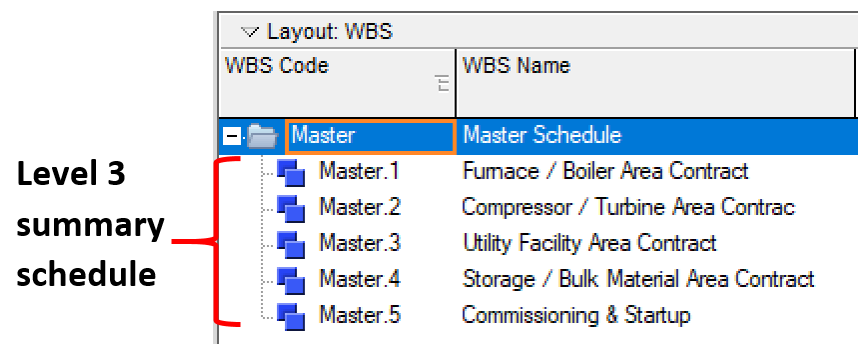

The planner develops a separate higher level schedule. Activities in the high level schedule, corresponds with the detailed contractors schedule.

High-Level Manual Schedule Diagram

4. Milestone-Driven Linking

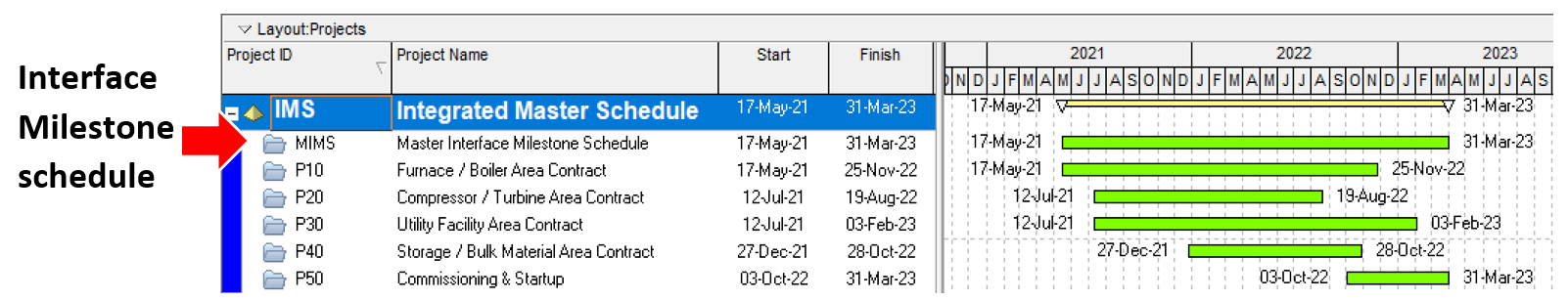

The planner creates a Milestone schedule then links the activities through this schedule. Updating is still a challenge either could be done automatically or manually. For manual update, multiple planners would be required.

Milestone Driven Diagram

Audit Your IMS Strategy

Does your IMS effectively support the project, or is it just a report?
Are you struggling with P6 database corruption from poor linking?
Does your team know the *purpose* of the IMS beyond the contract?

Build a Resilient IMS

Effective interface management reduces costs and eliminates claims. Don't let your project collapse into litigation.
