Sometimes during discussions on Weight Value, most people immediately jump to the conclusion that Man-Hours, Cost, etc. must be used. On some Projects, man-hours could be applicable whilst on others Cost. However, for other projects, it could be another factor. It is clear that one factor would not be applicable to all projects. The project’s scope of work, the purpose of PMS, interface with other project control components, etc. must be considered during the weight value calculations.

In the following example, we will illustrate the importance of the weight value. Example, there is an EPC project with the contractual value of $50 million. The contractor’s invoice will be paid as per the earned progress. The progress of the EPC at a certain stage is as follows:

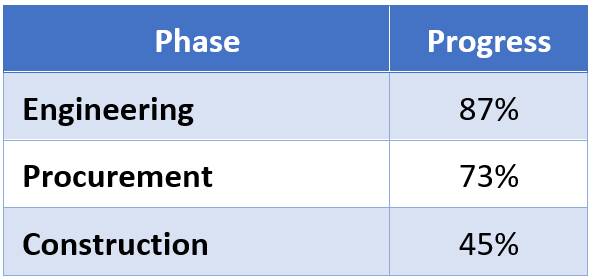

EPC Progress Breakdown
EPC progress breakdown at a certain stage

The overall project’s progress has been calculated using three (3) different weight values:

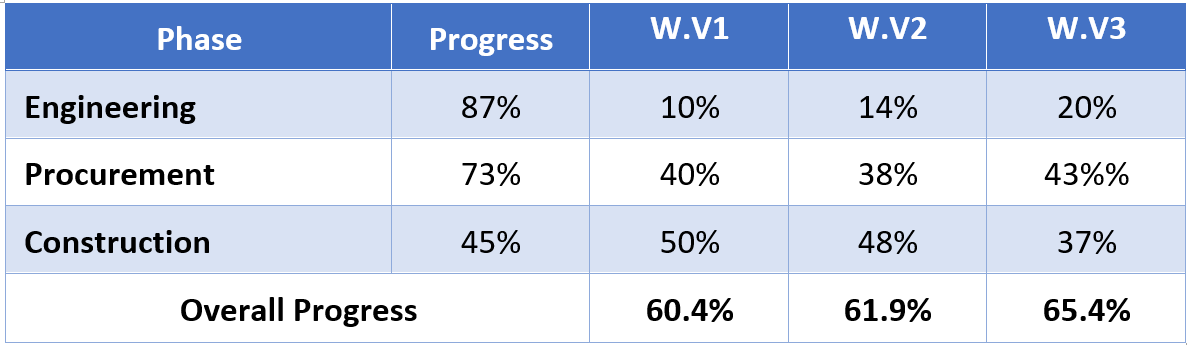

Three Different Weight Values Comparison
Three different weight values leading to different overall progress

The calculated overall project’s progresses are not the same due to weight value differences. As a result, the invoice value will not be the same. The invoice values based on each weight values are as follows:

  • Invoice 1: $30.20 million
  • Invoice 2: $30.97 million
  • Invoice 3: $32.72 million

The data source for most capital projects must be a Resource Loaded Schedule.

It is clear that any mistakes, miscalculations or incorrect criteria could have a massive impact on the company’s cash flow and capacity to deliver the project. So, for the calculation of the weight value, one cannot jump to the immediate conclusion and use man-hours, cost, etc.
